Reusing precast concrete elements in construction: assessing the economic conditions Cover

Reusing precast concrete elements in construction: assessing the economic conditions

Open Access
|Aug 2026

Figures & Tables

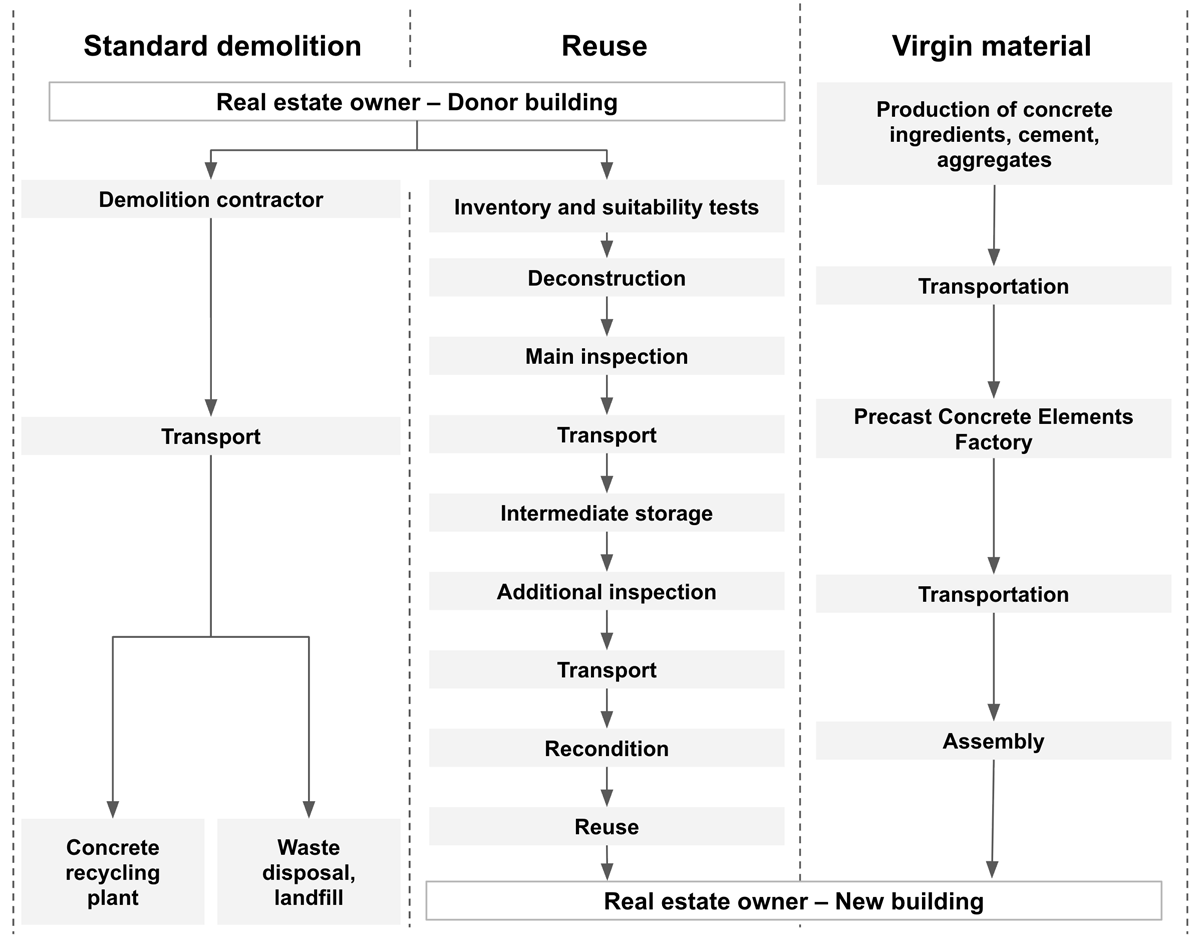

Figure 1

A supply-chain framework for analysing economic boundary conditions.

Table 1

Data sources

DOCUMENT TYPEDOCUMENT COUNT
Academic article17
Database/website11
Industry report19
Other report4
Firm internal document3
Total54
Table 2

Scenarios of how cost increases or decreases impact the total costs of an apartment building

PROJECT COSTSTRUCTURAL FRAME COSTSTRUCTURAL FRAME COST CHANGE (%)NEW PROJECT COSTPROJECT COST CHANGE (%)
€15,000,000€3,000,000–25%€14,250,000–5%
€15,000,000€3,000,000+25%€15,750,000+5%
€15,000,000€3,000,000+50%€16,500,000+10%
€15,000,000€3,000,000+75%€17,250,000+15%
Table 3

Summary of economic boundary conditions of reuse across decision points and system-level conditions

SUPPLY CHAIN STAGEDECISION POINT/CONDITIONKEY MECHANISMSEFFECT ON REUSEMAIN ACTORS
Donor stageDemolition vs deconstructionLabour costs vs waste costsContext-dependentOwner, contractor
Donor stageAssessments and reconditioningLabour costs and uncertaintyConstrainingEngineers, specialists
Donor stageDisposal, storage, reuse, or saleBalancing supply and demandConditional on demandOwner, intermediary
Buyer stageReuse vs virgin materialPrice and other benefits vs. availability and riskConditional on cost, availability, preferencesBuyer
Buyer stageDesign and compatibilityDesign costsConstrainingDesigners, architects
Buyer stageProcurement and coordinationTransaction costsConstrainingBuyer
System levelSupply-chain profitabilityValue creation and distributionRequires alignmentAll actors
System levelPolicy and regulationIncentives, risk reductionEnablingPolicymakers, public sector, all actors
Table 4

Research agenda: economic mechanisms and research gaps in PCE reuse

SUPPLY CHAIN STAGEDECISION POINT/CONDITIONRESEARCH GAPWHY IT MATTERS
Donor stageDemolition vs deconstructionCost structures of deconstructionCore determinant of supply-side feasibility
Donor stageAssessments and reconditioningCosts of inventory and assessmentKey source of costs and uncertainty
Donor stageDisposal, storage, reuse or salePCE prices and marketsLimits scaling of reuse markets
Buyer stageReuse vs virgin materialCost competitiveness and availabilityCore determinants of demand-side feasibility
Buyer stageDesign and compatibilityDesign costs and technical uncertaintyKey source of costs and uncertainty
Buyer stageProcurement and coordinationTransaction costsOften hidden costs that limit scalability
System levelSupply-chain profitabilityOverall cost-benefits, profitabilityFundamental condition for all actors
System levelPolicy and regulationPolicy impact and incentives designFundamental condition for all actors
DOI: https://doi.org/10.5334/bc.842 | Journal eISSN: 2632-6655
Language: English
Page range: 891 - 908
Submitted on: Apr 13, 2026
Accepted on: Jun 29, 2026
Published on: Aug 13, 2026
Published by: Ubiquity Press
In partnership with: Paradigm Publishing Services

© 2026 Olli Vigren, Helena Westerlind, Tove Malmqvist, published by Ubiquity Press
This work is licensed under the Creative Commons Attribution 4.0 License.
