Determination of construction process duration based on labor productivity estimation: A case study Cover

Determination of construction process duration based on labor productivity estimation: A case study

Open Access
|Nov 2021

Figures & Tables

Fig. 1

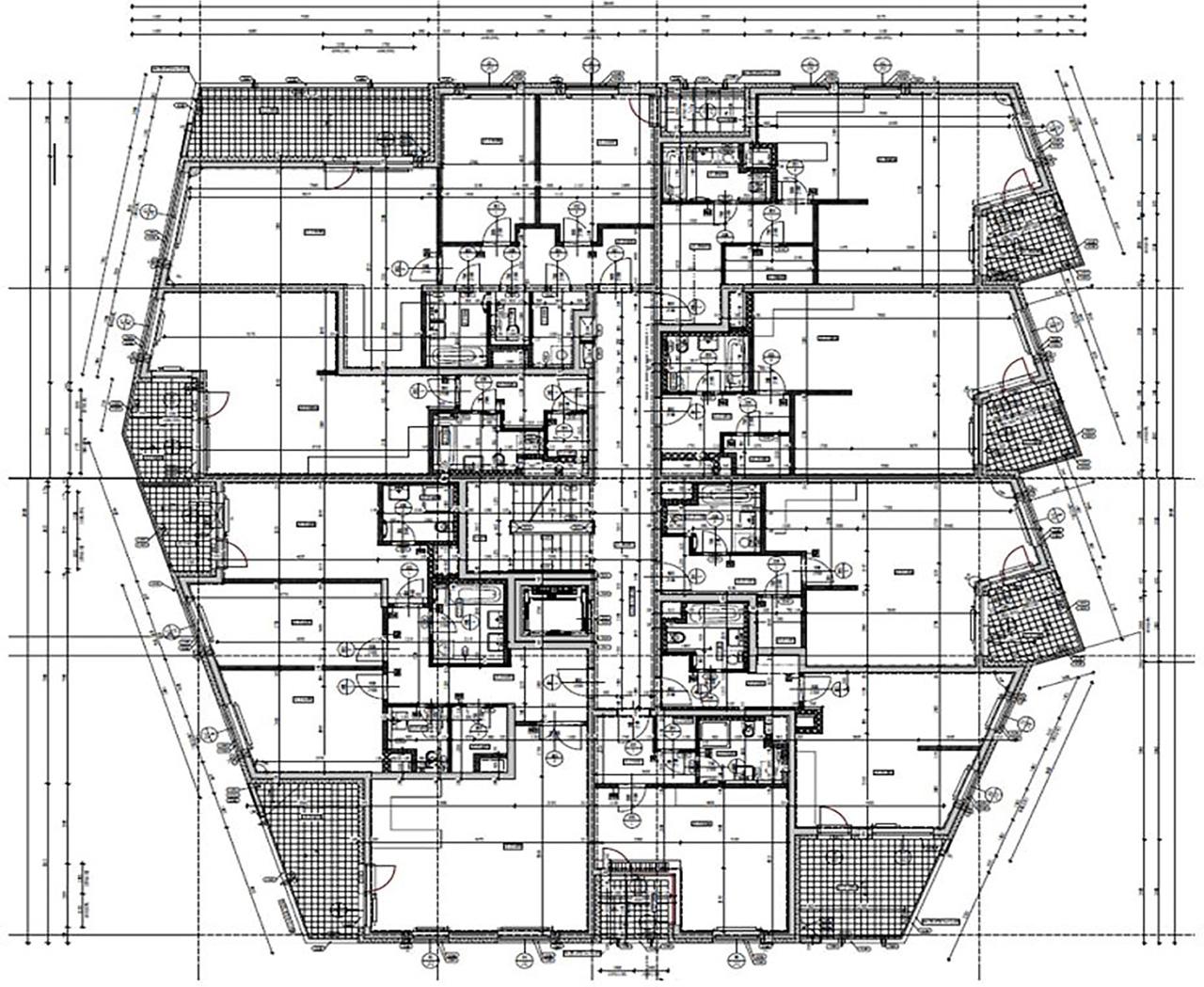

Type of above-ground floor of building J1–J2.
Type of above-ground floor of building J1–J2.

Fig. 2

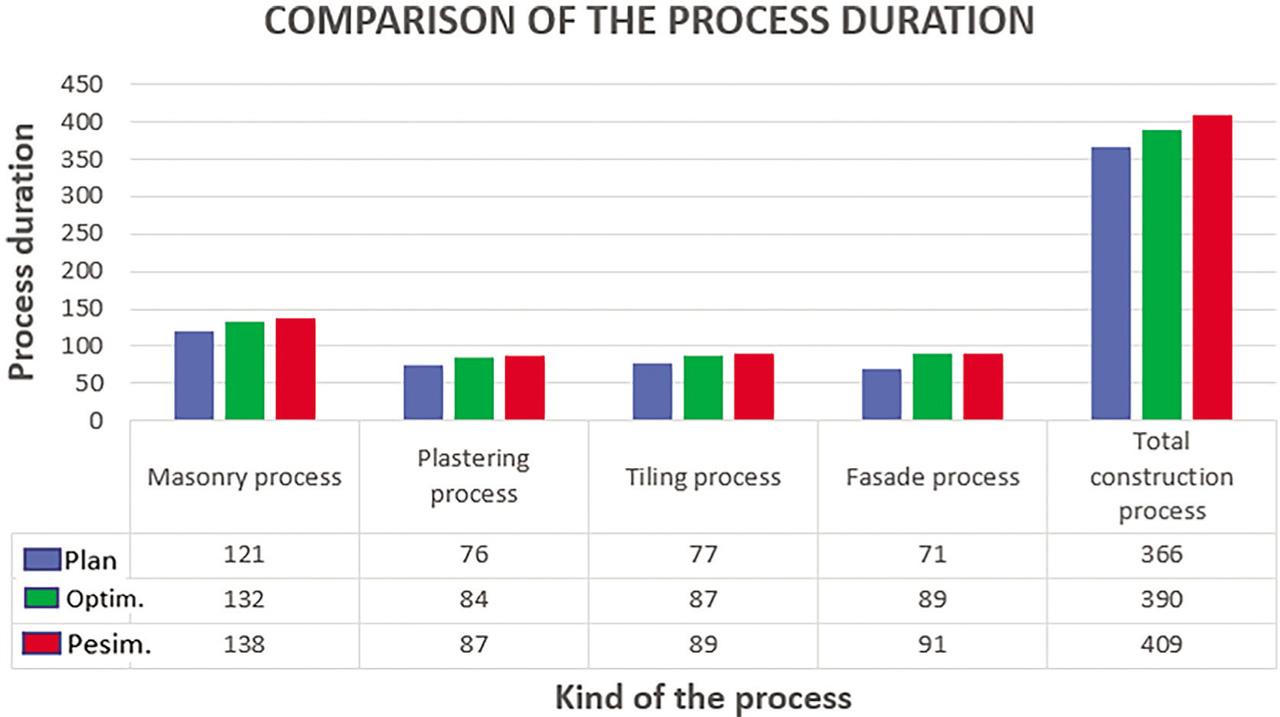

Comparison of process duration.
Comparison of process duration.

Plastering works – Distribution of number of plasterers in work queue no_1

FloorNo. of plasterersOverall performance plan m2/smOverall performance plan m2/month
1887.61,752
2887.61,752
3
4
5
6
7
ς16175.23,504

Plastering works SO J 34

Worker no.12345678910111213141516
Performance/shift12111012111312111012111013101211
Worker no.17181920212223242526272829303132
Performance/shift12111112111312111212111213121012

Calculation of observed value XOBS – originally wrongly numbered 2

OrderedSeries (i)(í−1)/ní/nF(x)D proD proD

Values x i/n(í−1)/n
10 1 00.0630.0360.0270.0360.036
10 2 0.0630.1250.0360.089−0.0270.089
1190.50.5630.2740.289 −0.2260.289
12100.5630.6250.726−0.101 0.1630.163
12110.6250.6880.726−0.038 0.1010.101
12120.6880.750.7260.024 0.0380.038
12130.750.8130.7260.087 −0.0240.087
12140.8130.8750.7260.149 −0.0870.149
13150.8750.9380.964−0.0260.0890.089
13160.93810.9640.0360.0260.036
