Skip to main content
Have a personal or library account? Click to login
An integration of spreadsheet and project management software for cost optimal time scheduling in construction Cover

An integration of spreadsheet and project management software for cost optimal time scheduling in construction

By:  and
Open Access
|Dec 2017

Figures & Tables

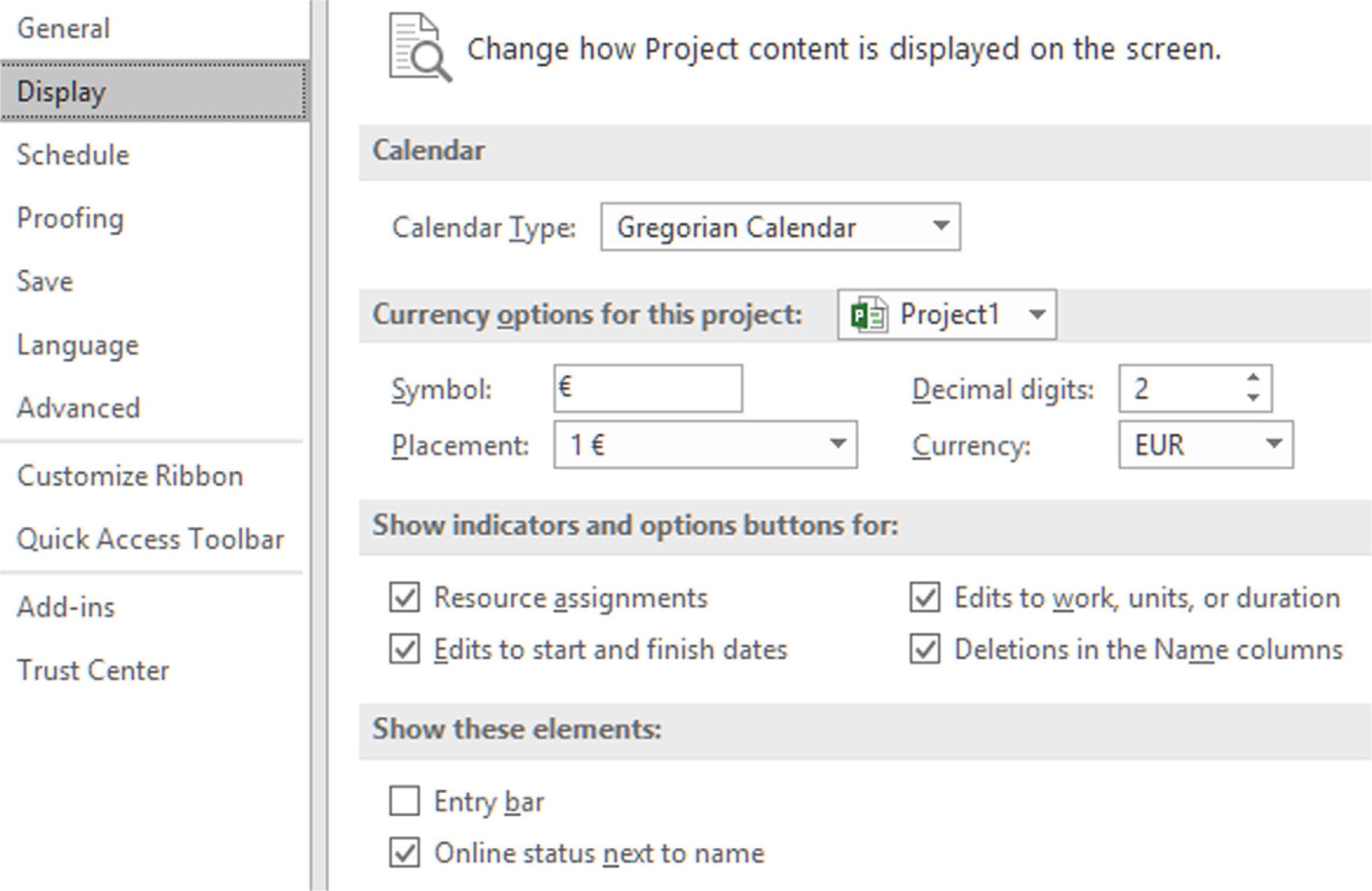

Fig. 1:

Project options.

Fig. 2:

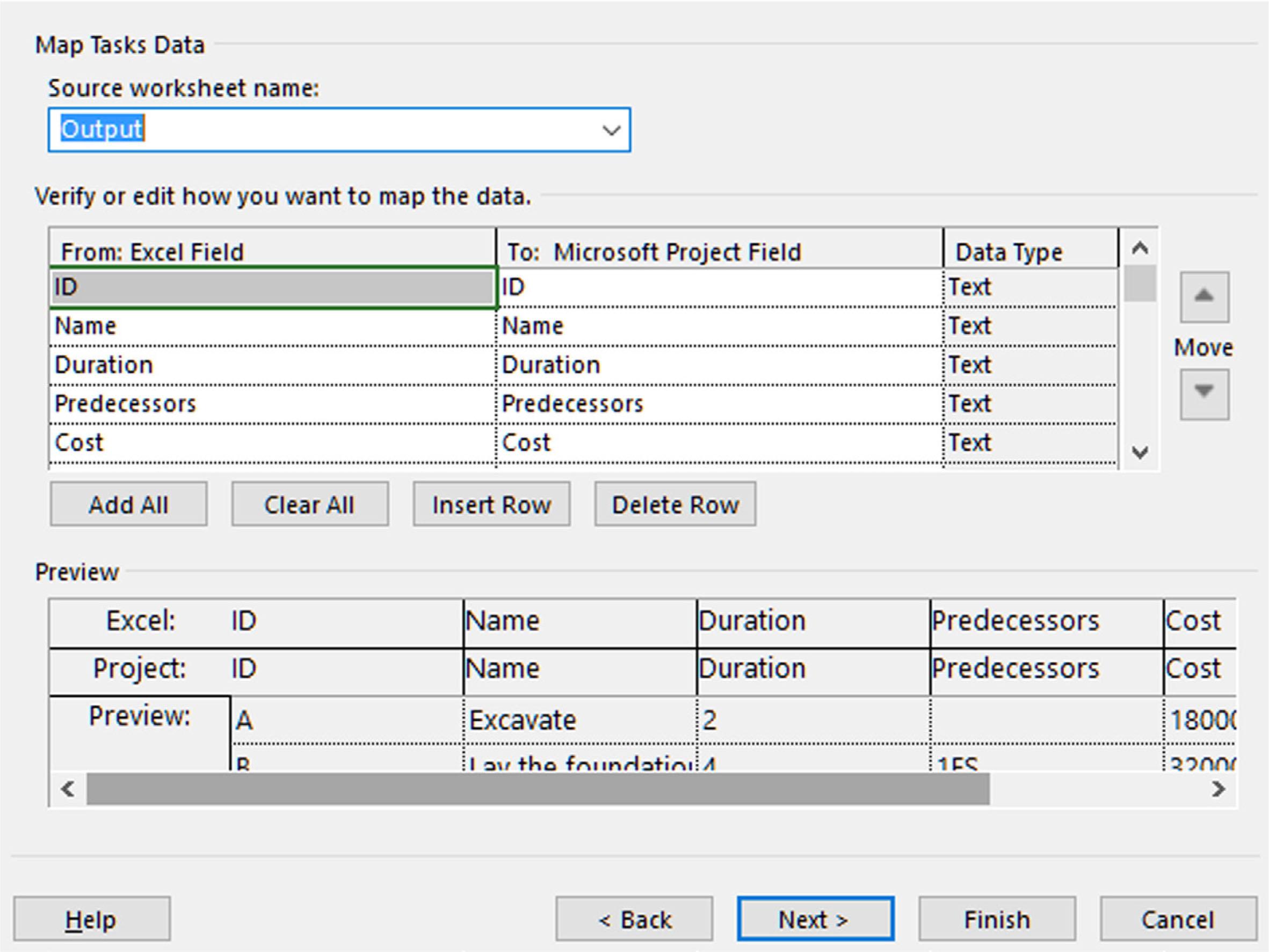

Import wizard.

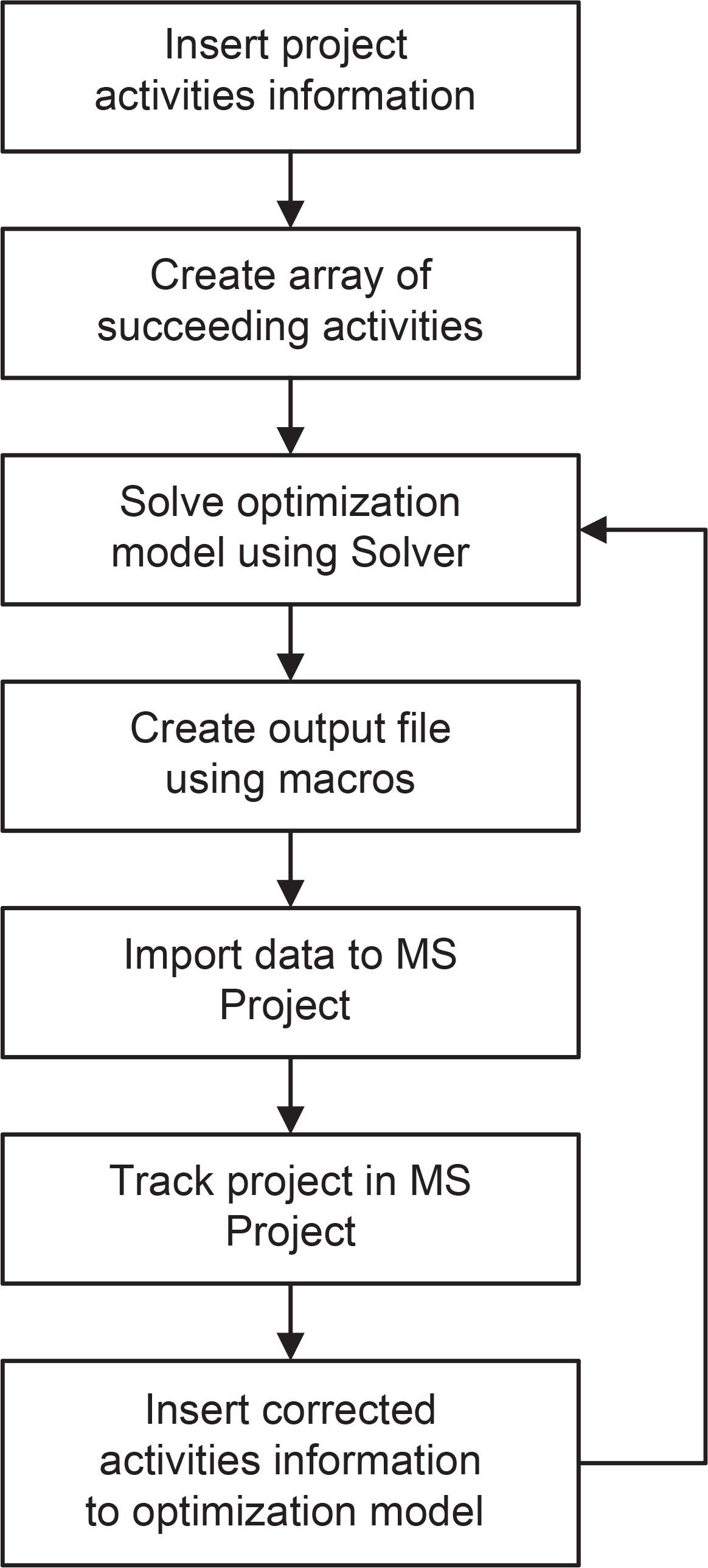

Fig. 3:

Usage steps of proposed integration of spreadsheet and PMS.

Tab. 1

Duration and direct costs of activities.

Activity IDDuration [weeks]Direct costDirect cost–duration function
Option 1Option 2Option 1Option 2
A12280000180000(380–100TA) × 103
B24420000320000(520–50TB) × 103
C710860000620000(1420–80TC) × 103
D46340000260000(500–40TD) × 103
E34570000410000(1050–160TE) × 103
F35260000180000(380–40TF) × 103
G471020000900000(1180–40TG) × 103
H69380000200000(740–60TH) × 103
I57270000210000(420–8300TL) × 103
J68490000430000(670–30TJ) × 103
K34200000160000(320–40TK) × 103
L35350000250000(500–50TL) × 103
M12200000100000(300–100TM) × 103
N36510000330000(690–60TN) × 103

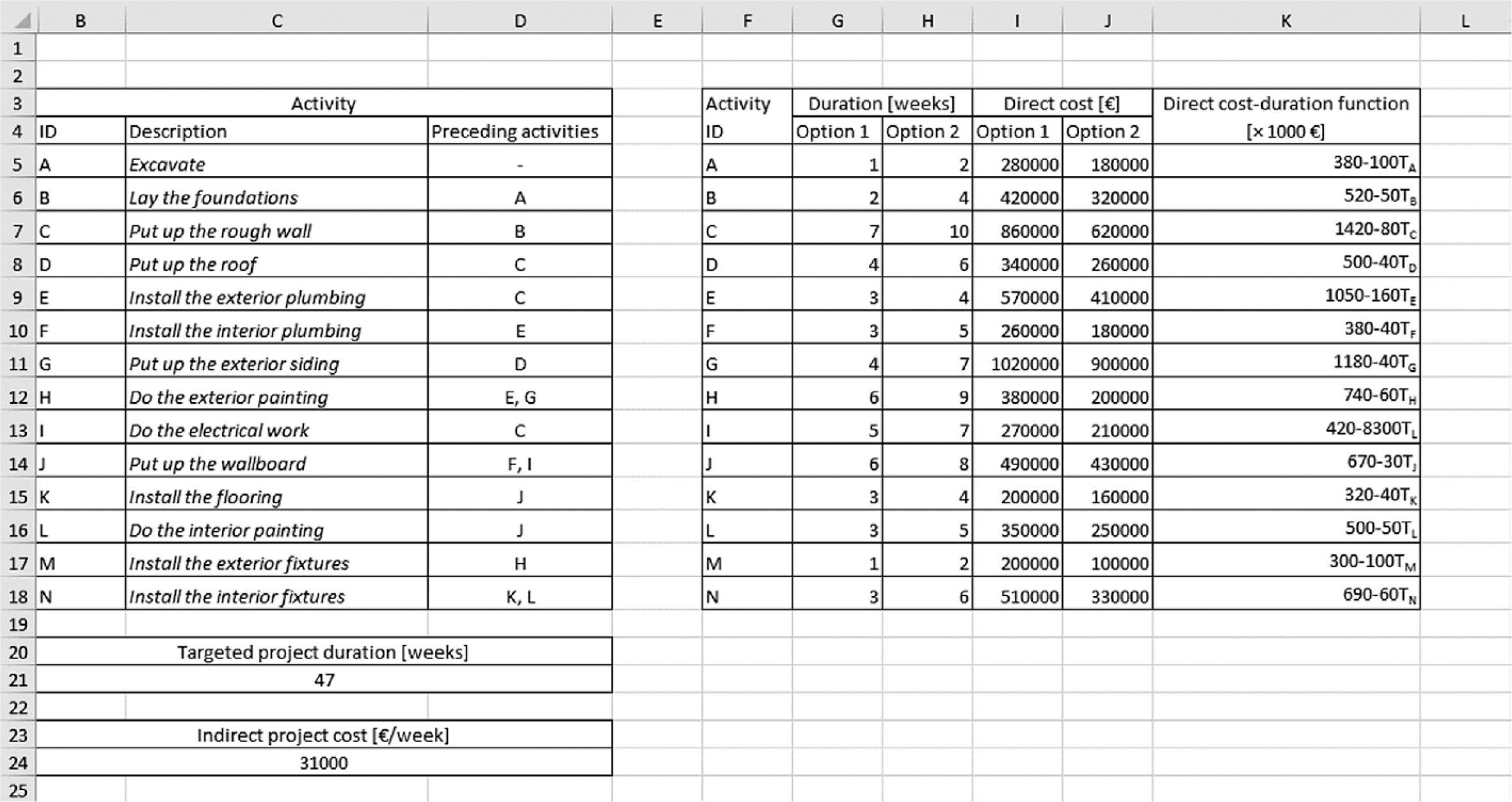

Fig. 4:

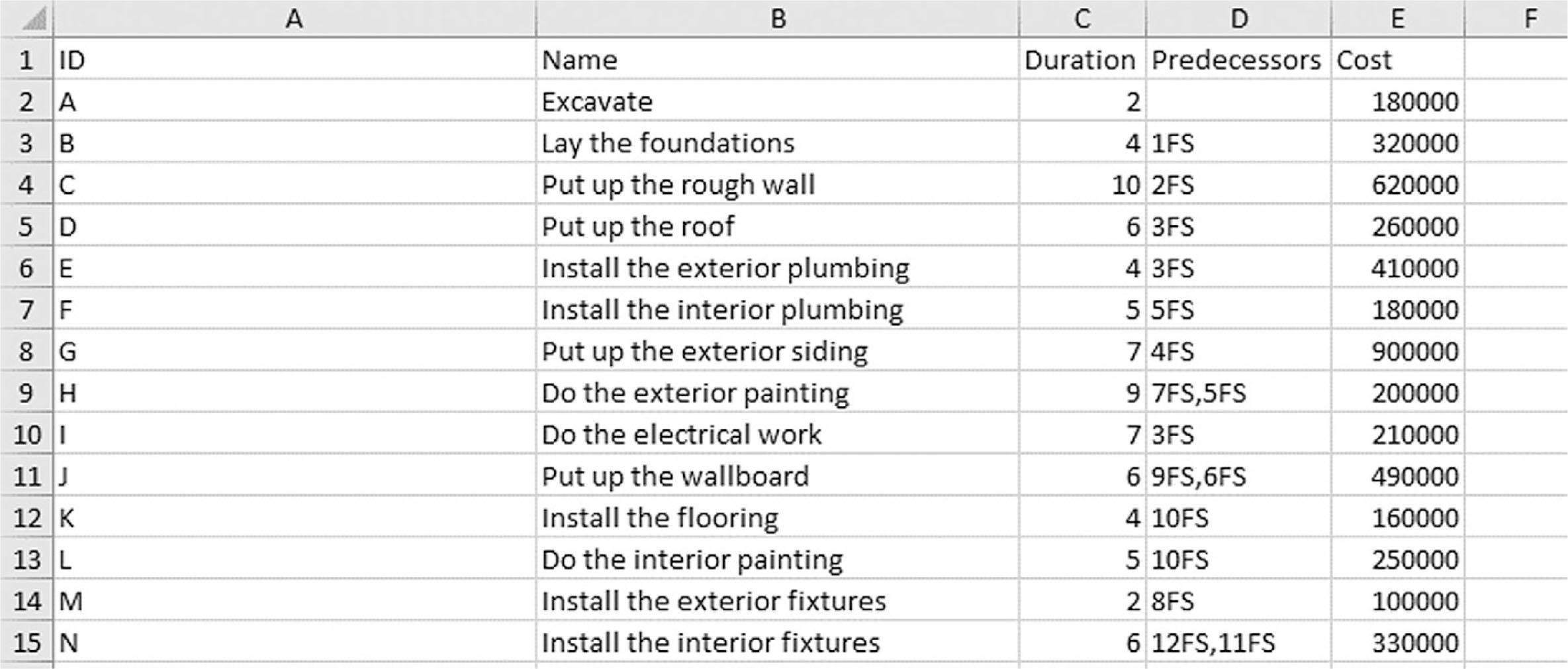

Input data in Microsoft Excel.

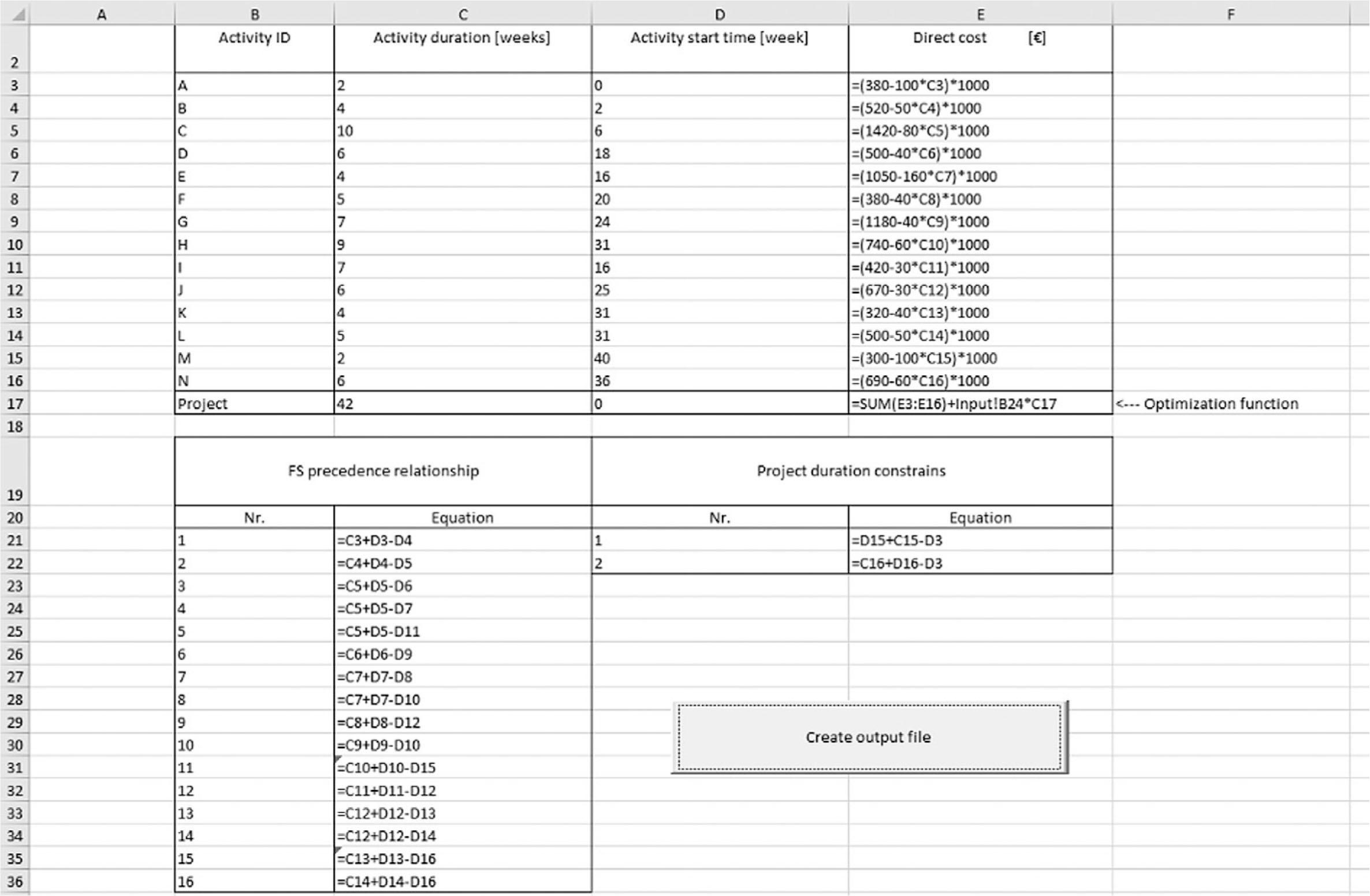

Fig. 5:

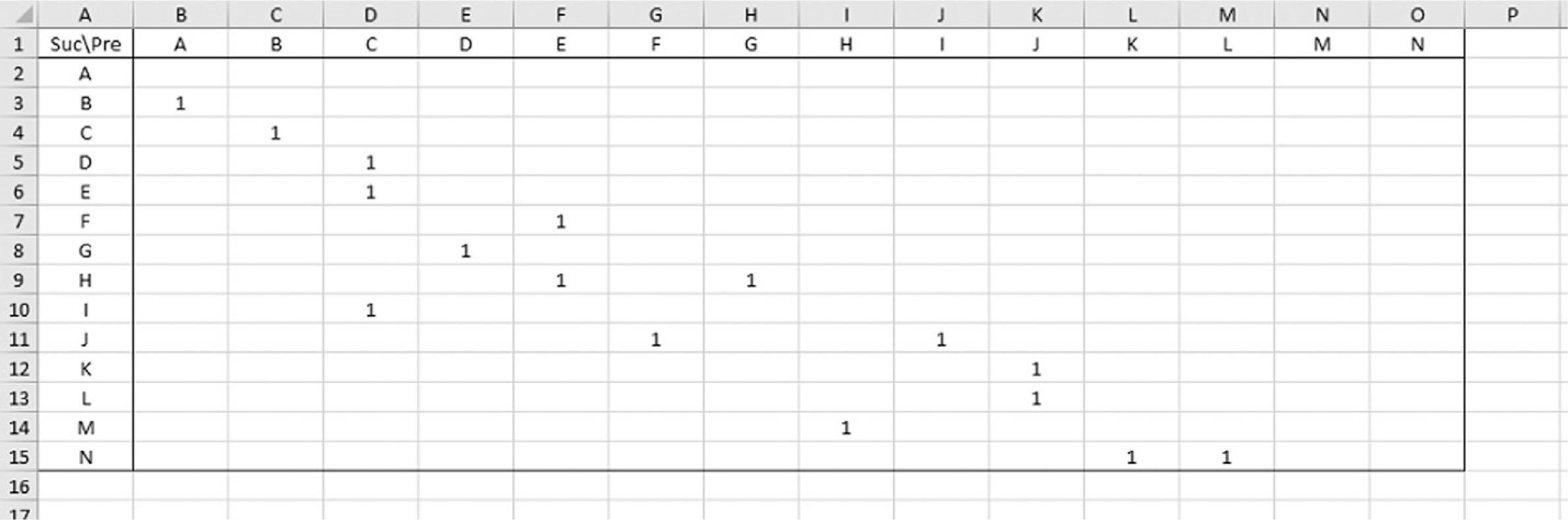

Array of activities.

Fig. 6:

Changing cells.

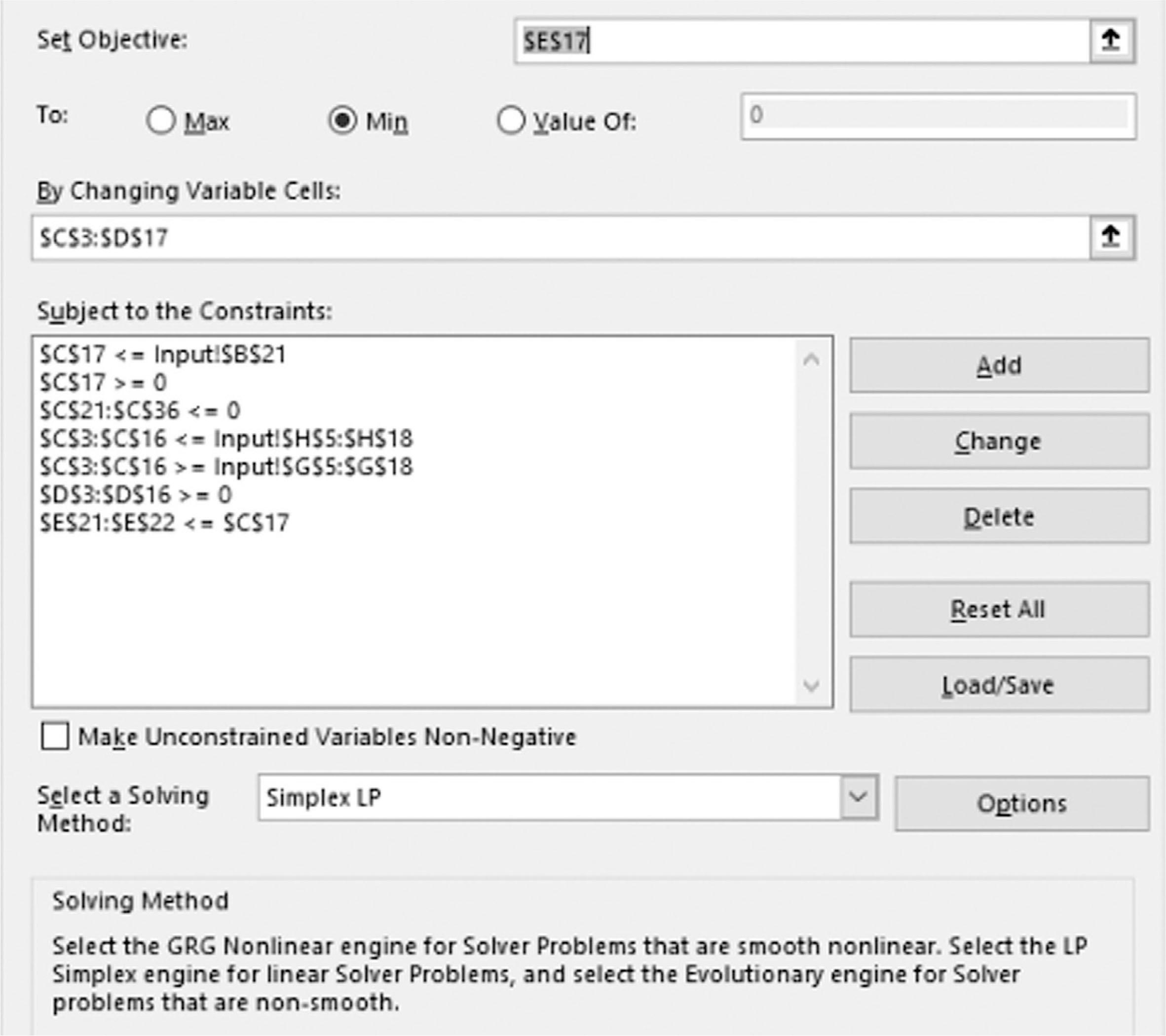

Fig. 7:

Settings in Solver.

Fig. 8:

Output file.

Fig. 9:

Optimal time schedule for example project.

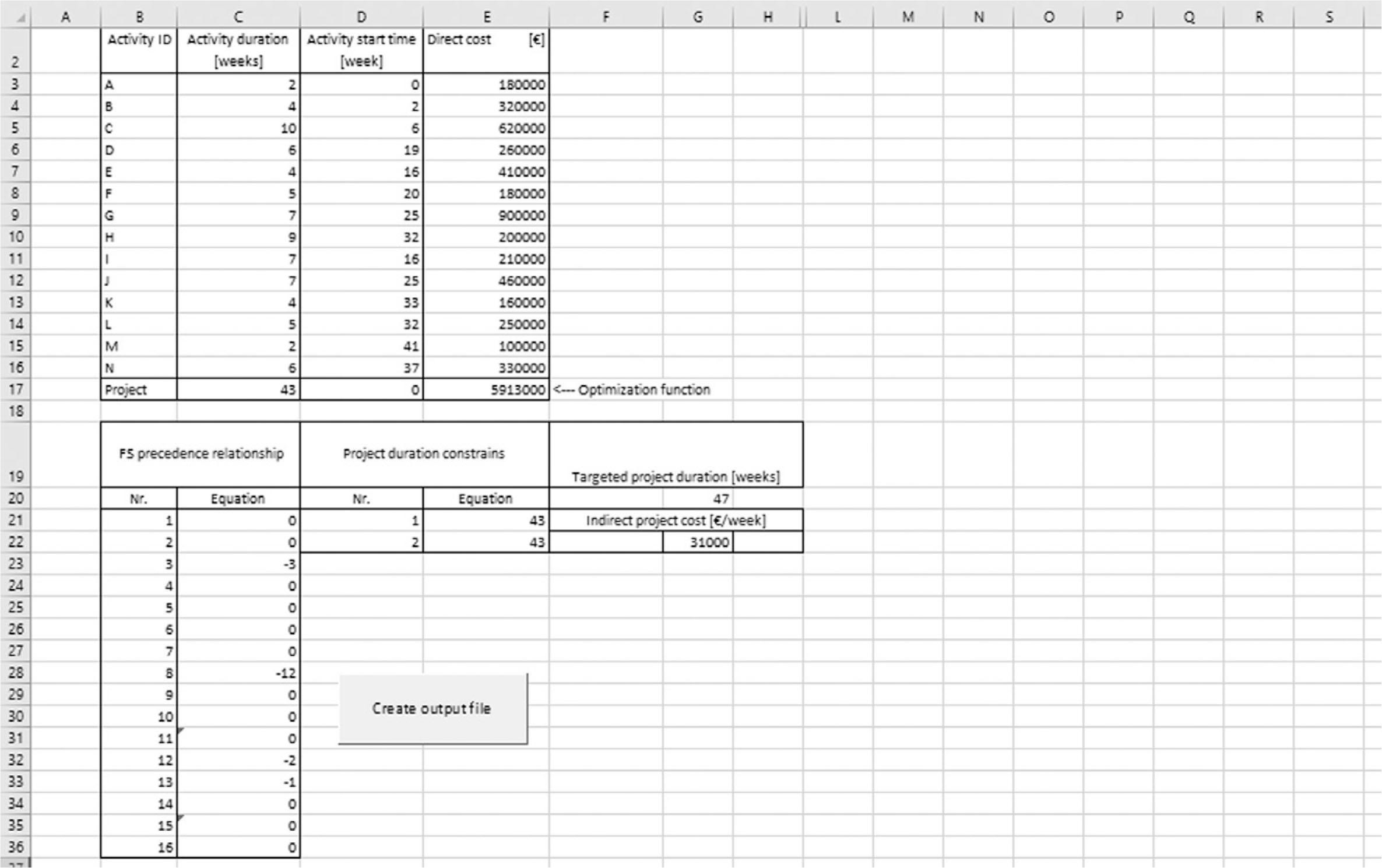

Fig. 10:

Updated optimal solution for example project.

Figure 11:

Updated time schedule for example project.
